THE COMPLETE BUSINESS PLAN
A specific operating decision.
Can the engineering roster support specialized review and the long invoice cycle within its fixed paid coverage?
Fictional editorial scenario. Prices, workload, wages, costs and financing are illustrative planning inputs, not current quotes, measured local averages or actual company results.
The forecast shows a net loss in Year 1. Positive funded cash assumes the full proposed equity is received; it does not establish commercial viability.
01 / THE PLAN
Executive summary
ContourOak Engineering proposes a small independent civil and structural design consultancy in Secondary US metro service area; jurisdiction unselected. A proposed civil/structural consultancy delivering scoped design analysis and construction support with paid engineering and CAD coverage. The central launch decision is: Can the engineering roster support specialized review and the long invoice cycle within its fixed paid coverage?
Business overview
Authorized small commercial owners and development-team sponsors commissioning a defined professional service within verified competence and permissions. One principal, one-and-a-half project-engineer coverage and half-time CAD coverage provide a shared 480 available-hour pool monthly. Five service types allocate sold hours once. The principal is already included in delivery and paid once; no additional owner delivery pool is added. The business will accept assignments within this service boundary and quote separately or refer work that falls outside it.
Key priorities
Complete a permitted paid limited study or review and record usable data, engineer/CAD effort, checking, client decisions and collection. A planned development does not establish a ready design commission. Demand must justify paid specialist coverage and the long invoice-credit period, rather than assuming future staff growth or treating all available hours as readily interchangeable work. The proposed first operating month is January 2027. The owner should confirm service readiness, paid staffing and available cash before opening the calendar.
Financial highlights
The proposal requires $231,677.78 in equity. Launch spending is $44,500.00, leaving $187,177.78 in opening cash. Year 1 revenue is $501,666.00 and net income is -$18,435.92. The first-year operating shortfall means sales do not yet cover the paid team and overhead. Funding provides time to establish demand; it does not remove that shortfall. The initial project outlay is not recovered within three operating years.
02 / THE PLAN
Company & management
ContourOak Engineering will operate as an independent service business. The working owner will control scope, staffing, commercial terms and weekly cash decisions; legal formation and the ownership agreement must be completed before trading.
Company background
ContourOak Engineering is a fictional independent consultancy in an unselected secondary US metropolitan area. It proposes a small leased office serving commercial development decisions and design/support scopes. Actual professional/entity permissions, qualified responsible review and jurisdiction-specific requirements remain to be verified. The plan does not establish an issued license or approved project.
Ownership & management
The proposed owner contribution is $231,677.78 and covers all modeled equity. No external equity is included. The owner is also paid for an operating role. Legal ownership, professional eligibility and distribution terms must be verified before trading.
Team & responsibilities
The paid delivery roster includes the owner principal engineer, one-and-a-half project-engineer coverage and half-time CAD support. Together they provide three delivery equivalents; the principal is not added again as a fourth worker. Fractional rows are prorated salary budgets. Aggregate hours do not make engineering and drafting skills interchangeable or establish simultaneous qualified review coverage. Owner engineer: 1 × $11,250.00 monthly, plus a 15% employer-cost allowance; Engineer budget: 1 × $12,500.00 monthly, plus a 15% employer-cost allowance; CAD budget: 1 × $2,833.33 monthly, plus a 15% employer-cost allowance. A weekly roster must cover delivery, preparation, travel, administration, leave and absence. The owner’s salary appears once in payroll; contributed time is not an additional cash contribution.
03 / THE PLAN
Products & business model
The offer is limited to work the team can define, price and deliver consistently. Each agreement should identify the buyer, included tasks, access requirements, deliverables, acceptance and payment terms.
Products & services
Civil site design, stormwater analysis, structural reviews, feasibility work and construction support share one sold-hour pool. Each engagement defines actual design/review responsibilities, inputs, deliverables and reliance limits. Specialist subconsultants, absorbed travel and outsourced reproduction are purchased separately. Any signed or sealed deliverable requires the actual competent and authorized professional arrangement to be established.
Pricing & revenue streams
3 paid engineering and CAD delivery equivalents provide 480.000 scheduled hours per month (160.000 per person). Requested sold time starts at 55% of allocated capacity and follows a 3-month ramp. Five service shares total 100%; each hour is allocated once. Uniform monthly demand is assumed. Requested work grows 0% annually, subject to the available-hour ceiling; fees grow 2% annually. Staffing stays fixed. Civil design: 35% of the shared capacity at $165.00 per billable hour. Stormwater: 20% of the shared capacity at $175.00 per billable hour. Structures: 20% of the shared capacity at $190.00 per billable hour. Feasibility: 15% of the shared capacity at $180.00 per billable hour. Site support: 10% of the shared capacity at $150.00 per billable hour. Fees exclude customer sales tax. Confirm scope and any exceptional materials before accepting a fixed price.
Customer value
The proposed benefit is a clearly scoped technical decision or deliverable with documented assumptions, checking and responsibility. Clients should know which surveys, site data or other disciplines remain outside scope. The company would not guarantee permit approval, construction cost or a building outcome merely because its forecast contains a paid design category.
04 / THE PLAN
Market & competition
The initial market is the specific buyer and buying occasion described below. The launch should be justified by paid work in a practical service area, rather than by applying a market-share percentage to a broad industry estimate.
Target customers
Authorized small commercial owners and development-team sponsors commissioning a defined professional service within verified competence and permissions. Confirm who commissions the work, who supplies access or records and who authorizes payment. Keep the initial territory small enough to support the promised response and delivery time.
Demand & validation
Complete a permitted paid limited study or review and record usable data, engineer/CAD effort, checking, client decisions and collection. A planned development does not establish a ready design commission. Demand must justify paid specialist coverage and the long invoice-credit period, rather than assuming future staff growth or treating all available hours as readily interchangeable work.
Competition & positioning
Alternatives include other suitable engineering firms, independent specialists and a client's existing design team. Compare discipline, deliverable, inputs, checking, responsibility and fee terms. A contractor's construction estimate is not comparable with professional analysis. No local rate average, approval-speed claim, technical superiority or measured market share is asserted.
05 / THE PLAN
Marketing & sales
The acquisition process should bring in work that fits the team and produces collected contribution after delivery costs. Track qualified opportunities, accepted quotes, completed work and cash received as separate steps.
Customer acquisition
Proposed channels are appropriate architect/developer introductions, scoped technical explanations and professional relationships. Marketing/proposal expense is separate from owner pay. Qualify project readiness, relevant competence, client authority and payment before developing a full proposal. Do not imply an issued registration, real project credit or public approval that has not been established.
Sales process
Agree the professional scope, supplied survey/data, interfaces with other disciplines, deliverables, review/change process and invoice terms before work. The forecast uses a long customer collection delay without treating unbilled work as cash. Actual milestone billing, retainage or suspended projects require a separate cash review. Additional design changes need an authorized fee and schedule.
Retention & measurement
Close with accepted deliverables and a clear record of continuing responsibilities, then scope any subsequent site phase separately. Track rework causes, missing client inputs, reliance requests and overdue invoices. Further project stages are not automatic renewal revenue. Construction outcomes should not be claimed as proof of design performance without relevant project-specific evidence.
06 / THE PLAN
Operations & milestones
Delivery must fit the paid team’s hours, equipment and service window. Work should enter the calendar only after scope, competence, access and required resources are confirmed.
Facilities & resources
Launch assets are CAD workstations, furniture, inspection/measurement equipment, a plotter/printer and secure network/backup hardware. Project reproduction and specialists are direct purchases; internal software is overhead. There is no tangible resale stock. Confirm configured technical tools, licenses, secure records and professional cover before relying on the equipment and office allowances. The launch asset budget is CAD workstations and monitors: $12,000.00; Office furniture: $8,000.00; Inspection and measurement equipment: $5,000.00; Plotter and office printer: $3,500.00; Network and backup equipment: $2,500.00.
Service delivery
Confirm scope and competence, check usable site inputs, assign engineering/CAD work, coordinate interfaces, complete documented checking and hand over the agreed deliverable. Identify who can approve or issue each professional output. The initial roster remains fixed, so a real discipline and reviewer schedule must support each promised date before acceptance.
Launch & development milestones
Verify actual permissions and responsible professional coverage, contracts, insurance and configured tools before trading. Complete a paid limited deliverable through invoice collection. Inspect the reserve under slower payment before making a longer office commitment. The first-year net loss remains visible; future project-engineer expansion from the source estimate is omitted.
07 / THE PLAN
Funding request & use of funds
All proposed equity must be available before launch payments. The funding plan separates equipment and setup spending from the cash reserve needed to support operations.
Use of funds
Launch spending totals $44,500.00: $31,000.00 for assets, $13,500.00 for expensed setup and $0.00 for opening inventory. Setup covers an allowance for formation, professional preparation, training and launch work. Refundable premises deposits and additional site work are excluded until scoped quotes are available.
Sources of funding
Total proposed equity is $231,677.78, entirely from the owner. This contribution is uncommitted. No external investors or borrowing are included, and financing receipts are separate from earned revenue.
Owner contribution
The owner must confirm the availability and transfer date of the $231,677.78 contribution. Salary pays for the owner’s continuing operating work. The company still needs cash for payroll, equipment and supplier invoices, even when the owner contributes additional time.
Funding request
No external equity is requested. Receiving the proposed owner equity leaves $187,177.78 of opening cash and a forecast funding gap of $0.00. Confirm the owner's available funds and transfer date before committing launch payments.
08 / THE PLAN
Financial plan
The forecast covers January 2027–December 2029 in USD, with launch spending reported separately. Its usefulness depends on the service mix, fee, staffing cost and collection terms below.
Forecast assumptions
3 paid engineering and CAD delivery equivalents provide 480.000 scheduled hours per month (160.000 per person). Requested sold time starts at 55% of allocated capacity and follows a 3-month ramp. Five service shares total 100%; each hour is allocated once. Uniform monthly demand is assumed. Requested work grows 0% annually, subject to the available-hour ceiling; fees grow 2% annually. Staffing stays fixed. Direct costs are 8% of net fees. No product resale or purchased inventory is included. Salaries are operating expenses, outside the direct-cost ratio. Salaries and fixed overhead grow 3% annually. Collections take 45 days, supplier payments 0 days and inventory coverage 0 days. The 21% flat income-tax provision and 15% employer-cost allowance are simplified planning inputs.
Financial outlook
Year 1: revenue $501,666.00, EBITDA -$5,438.92, net income -$18,435.92 and closing cash $108,466.19. Year 2: revenue $558,217.44, EBITDA $32,039.88, net income $18,886.14 and closing cash $134,117.49. Year 3: revenue $569,381.76, EBITDA $27,937.68, net income $15,645.43 and closing cash $156,500.71. The first-year operating shortfall means sales do not yet cover the paid team and overhead. Funding provides time to establish demand; it does not remove that shortfall. EBITDA excludes depreciation, interest and income tax; net income includes depreciation and the tax provision.
Cash needs & financial resilience
The lowest forecast cash balance is $88,406.64, and the funding gap is $0.00. Positive monthly operating EBITDA is first reached in month 3. The initial project outlay is not recovered within three operating years. Cash differs from profit because of equipment spending, depreciation, collection delays and financing. Review the monthly low point before committing the reserve.
Debt & repayment
No debt or investor distributions are included. Any borrowing option needs an amount, draw date, interest rate and repayment schedule before its affordability can be assessed. Pre-tax project payback measures recovery of the operating investment; it is not a promised dividend, investor return or financing approval.
09 / THE PLAN
Risks & contingencies
The main exposure is committing paid resources before collected sales justify them. The owner should use the service-specific risks below to decide when to narrow the offer, defer spending or stop.
Key risks
Missing surveys, design changes, discipline interfaces, reliance disputes and delayed fees can absorb paid specialist time. A small team can lose critical review capacity through absence. The forecast uses pooled hours and average collection rather than a complete project/backlog or professional-review schedule; those limits can change the practical workload and reserve.
Contingency actions
Use scope/data-readiness gates, identified review responsibility, written change decisions and a weekly project/cash review. Compare collected fees with full engineer, CAD and subconsultant effort. Test project delay and slower invoices while retaining salaries. Decline or re-scope commitments when the relevant competence, review capacity or cash is unavailable.
10 / THE PLAN
Supporting documents
The launch decision needs commercial evidence as well as a forecast. Maintain an organized working file so that costs, commitments and delivery capacity can be reviewed before money is spent.
Available supporting information
The operating proposal defines the customer, service boundary, paid roles, launch assets and collection terms. The accompanying annual financial statements set out earnings, cash flow and the balance sheet for the three-year period. All funding remains a proposal; the business is at the prelaunch stage.
Documents to obtain
Verified professional/entity permissions, responsible review and discipline coverage, client scope/reliance and data agreements, configured tool and insurance quotes, actual paid deliverable/collection records and owner-funding availability remain outstanding. No sealed design, issued permit, professional certificate or committed customer project is supplied. Record the actual fee, total delivery effort and date of payment for each trial assignment. Update the forecast and funding decision when quotes, commitments or measured results change a material assumption.
02 / THE FINANCIAL MODEL
How this business earns and uses cash.
3 paid engineering and CAD delivery equivalents provide 480.000 scheduled hours per month (160.000 per person). Requested sold time starts at 55% of allocated capacity and follows a 3-month ramp. Five service shares total 100%; each hour is allocated once. Uniform monthly demand is assumed. Requested work grows 0% annually, subject to the available-hour ceiling; fees grow 2% annually. Staffing stays fixed.
The forecast covers three operating years, with prelaunch spending shown separately. Fees, workload, staffing and collection terms determine whether the business can cover its commitments and preserve cash.
| Service | Pool allocation | Base price | Billing unit |
|---|---|---|---|
| Civil design | 35% | $165.00 | One sold hour |
| Stormwater | 20% | $175.00 | One sold hour |
| Structures | 20% | $190.00 | One sold hour |
| Feasibility | 15% | $180.00 | One sold hour |
| Site support | 10% | $150.00 | One sold hour |
| Cost or paid role | Base input | Treatment |
|---|---|---|
| Owner engineer | $11,250.00/month before employer costs | Paid role; 15% employer allowance |
| Engineer budget | $12,500.00/month before employer costs | Paid role; 15% employer allowance |
| CAD budget | $2,833.33/month before employer costs | Paid role; 15% employer allowance |
| Office occupancy and utilities | $2,600.00/month before employer costs | Operating expense |
| Design and project software | $1,800.00/month before employer costs | Operating expense |
| Professional and business insurance | $900.00/month before employer costs | Operating expense |
| Accounting and legal services | $750.00/month before employer costs | Operating expense |
| Internet phones and IT support | $350.00/month before employer costs | Operating expense |
| Marketing and proposal materials | $750.00/month before employer costs | Operating expense |
| Licenses memberships and training | $400.00/month before employer costs | Operating expense |
| Office supplies and maintenance | $250.00/month before employer costs | Operating expense |
| Credit-loss expense | 1% of net fees | Operating expense |
| Payment processing | 0.3% of net fees | Operating expense |
| Input | Case value |
|---|---|
| Collection delay | 45 days |
| Inventory / supplier payment | 0 days / 0 days |
| Direct costs | 8% of net fees |
| Price / requested-demand growth | 2% / 0% annually |
| Salary and fixed-cost growth | 3% annually |
| Income-tax provision | 21% simplified provision |
| Proposed owner equity | $231,677.78 |
| Proposed external equity | $0.00 |
| Prelaunch setup | $13,500.00 |
Direct costs cover 8% of fees and exclude the paid roles already shown in operating expenses. The selected advisory/service format has no purchased inventory. All-in customer prices are not duplicated as extra parts or product revenue.
What the forecast shows
The forecast shows a net loss in Year 1. Net income includes depreciation and the monthly tax provision. EBITDA excludes depreciation, interest and tax; cash also reflects assets, working capital and financing.
| Measure | Year 1 · 2027 | Year 2 · 2028 | Year 3 · 2029 |
|---|---|---|---|
| Revenue | $501,666.00 | $558,217.44 | $569,381.76 |
| Cost of sales | $40,133.28 | $44,657.28 | $45,550.56 |
| Gross profit | $461,532.72 | $513,560.16 | $523,831.20 |
| Operating expenses | $466,971.64 | $481,520.28 | $495,893.52 |
| EBITDA | -$5,438.92 | $32,039.88 | $27,937.68 |
| Depreciation | $8,133.33 | $8,133.34 | $8,133.33 |
| Interest | $0.00 | $0.00 | $0.00 |
| Tax provision | $4,863.67 | $5,020.40 | $4,158.92 |
| Net income | -$18,435.92 | $18,886.14 | $15,645.43 |
| Measure | Year 1 · 2027 | Year 2 · 2028 | Year 3 · 2029 |
|---|---|---|---|
| Opening cash | $187,177.78 | $108,466.19 | $134,117.49 |
| Customer collections | $433,257.00 | $556,849.26 | $567,986.22 |
| Supplier payments | $40,133.28 | $44,657.28 | $45,550.56 |
| Operating expenses paid | $466,971.64 | $481,520.28 | $495,893.52 |
| Interest paid | $0.00 | $0.00 | $0.00 |
| Tax provision paid | $4,863.67 | $5,020.40 | $4,158.92 |
| Operating cash flow | -$78,711.59 | $25,651.30 | $22,383.22 |
| Investing cash flow | $0.00 | $0.00 | $0.00 |
| Financing cash flow | $0.00 | $0.00 | $0.00 |
| Net change | -$78,711.59 | $25,651.30 | $22,383.22 |
| Closing cash | $108,466.19 | $134,117.49 | $156,500.71 |
| Measure | Year 1 · 2027 | Year 2 · 2028 | Year 3 · 2029 |
|---|---|---|---|
| Cash | $108,466.19 | $134,117.49 | $156,500.71 |
| Receivables | $68,409.00 | $69,777.18 | $71,172.72 |
| Inventory | $0.00 | $0.00 | $0.00 |
| Net fixed assets | $22,866.67 | $14,733.33 | $6,600.00 |
| Assets | $199,741.86 | $218,628.00 | $234,273.43 |
| Payables | $0.00 | $0.00 | $0.00 |
| Loan balance | $0.00 | $0.00 | $0.00 |
| Liabilities | $0.00 | $0.00 | $0.00 |
| Equity and retained earnings | $199,741.86 | $218,628.00 | $234,273.43 |
| Reconciliation difference | $0.00 | $0.00 | $0.00 |
Launch spending is $44,500.00; opening cash is $187,177.78 after all proposed equity. The unfunded gap is $0.00. Pre-tax project payback is not reached within 36 months. Project recovery is not an investor distribution.

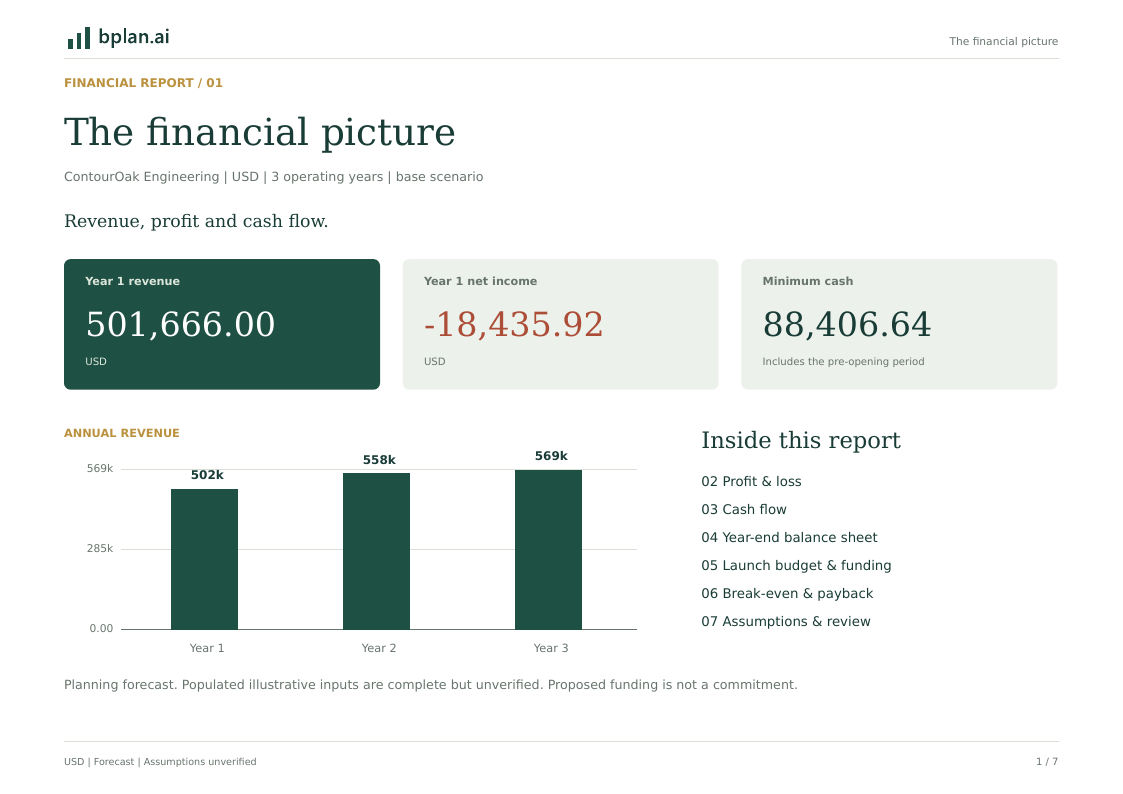

Inspect the actual report
Planning limits and qualifications
Planning model, not audited accounts or tax advice. Revenue is invoiced as earned; monthly subscriptions only. Annual prepayments, refundable deposits, milestone invoices, unbilled contract assets, customer taxes, seller settlements, capitalized interest and tax-loss carryforwards are not modeled.
Collection and supplier terms use 30-day monthly interpolation. Inventory purchases and non-stock direct costs use supplier terms; operating costs, setup costs, taxes and opening stock are paid immediately. Stock coverage applies only to linked goods costs. Production stock is tracked separately at unit cost.
Fictional editorial scenario. Prices, workload, wages, costs and financing are illustrative planning inputs, not current quotes, measured local averages or actual company results.
Five-year source narrowed to Jan 2027–Dec 2029; initial paid roster, mix and base fees retained. Later expansion omitted. Fixed utilization and three-month ramp; fees grow 2%, paid/fixed costs 3%. Fractional rows are prorated budgets. Owner pay counted once. Stock uses physical goods days; supplier lag is blended. Deposits/prepayments excluded; setup paid once. Source noncash loss allowances become conservative cash buffers. Tax/employer allowances illustrative.
A 15% illustrative employer allowance is added to paid salaries. The flat 21% native tax provision is a simplified planning input, not an entity or personal tax opinion. Customer sales-tax receipts/remittances and owner distributions are outside this scenario.
All equity is proposed, uncommitted month-0 cash. No debt is modeled. Opening cash is a reserve, not an extra startup expense. Asset/setup/insurance/premises allowances need scoped quotes; refundable premises deposits and site-specific additional works are excluded.
Fictional editorial scenario. Prices, workload, wages, costs and financing are illustrative planning inputs, not current quotes, measured local averages or actual company results.
Five-year source narrowed to Jan 2027–Dec 2029; initial paid roster, mix and base fees retained. Later expansion omitted. Fixed utilization and three-month ramp; fees grow 2%, paid/fixed costs 3%. Fractional rows are prorated budgets. Owner pay counted once. Stock uses physical goods days; supplier lag is blended. Deposits/prepayments excluded; setup paid once. Source noncash loss allowances become conservative cash buffers. Tax/employer allowances illustrative.
A 15% illustrative employer allowance is added to paid salaries. The flat 21% native tax provision is a simplified planning input, not an entity or personal tax opinion. Customer sales-tax receipts/remittances and owner distributions are outside this scenario.
All equity is proposed, uncommitted month-0 cash. No debt is modeled. Opening cash is a reserve, not an extra startup expense. Asset/setup/insurance/premises allowances need scoped quotes; refundable premises deposits and site-specific additional works are excluded.
03 / ACTUAL TEN-SLIDE PITCH
A focused funding conversation.
All ten pages of the delivered PDF. Buyer demand, team roles and funding remain proposed.
ContourOak Engineering
Every slide is available in the complete ten-slide PDF. The full slide text follows.
Read the complete slide outline
1. ContourOak Engineering
Defined technical work. Named review responsibility.
Fictional prelaunch

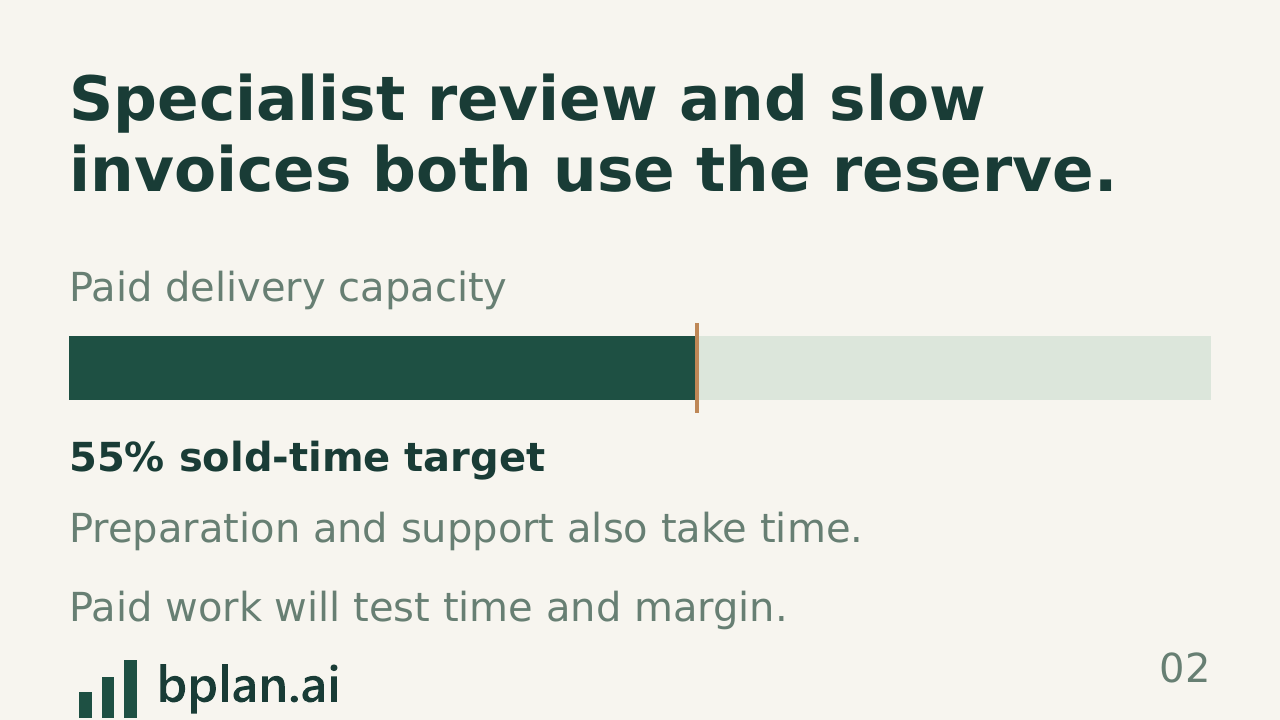

2. Specialist review and slow invoices both use the reserve.
Paid delivery capacity
55% sold-time target
Preparation and support also take time.
Paid work will test time and margin.
3. A clear scope. A controlled delivery process.
Agree
Schedule
Deliver
Collect
One agreed scope. Documented acceptance.

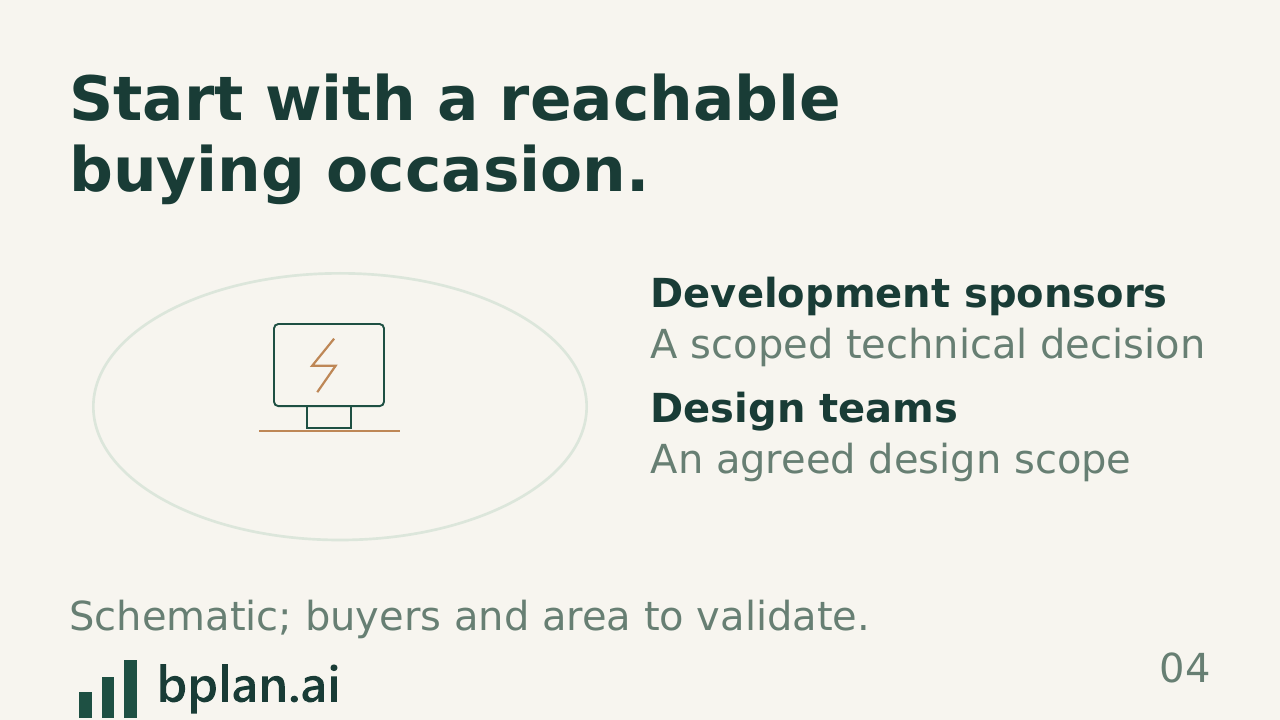

4. Start with a reachable buying occasion.
Development sponsors
A scoped technical decision
Design teams
An agreed design scope
Schematic; buyers and area to validate.

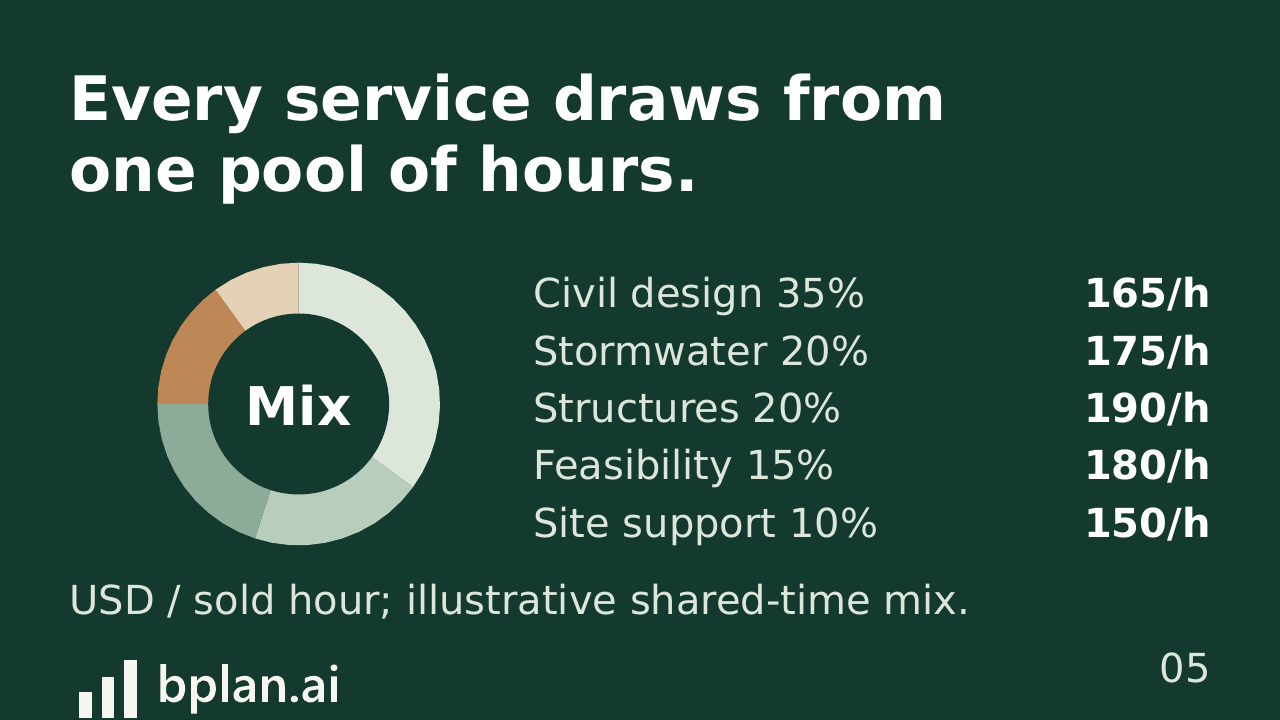

5. Every service draws from one pool of hours.
Mix
Civil design 35%
165/h
Stormwater 20%
175/h
Structures 20%
190/h
Feasibility 15%
180/h
Site support 10%
150/h
USD / sold hour; illustrative shared-time mix.

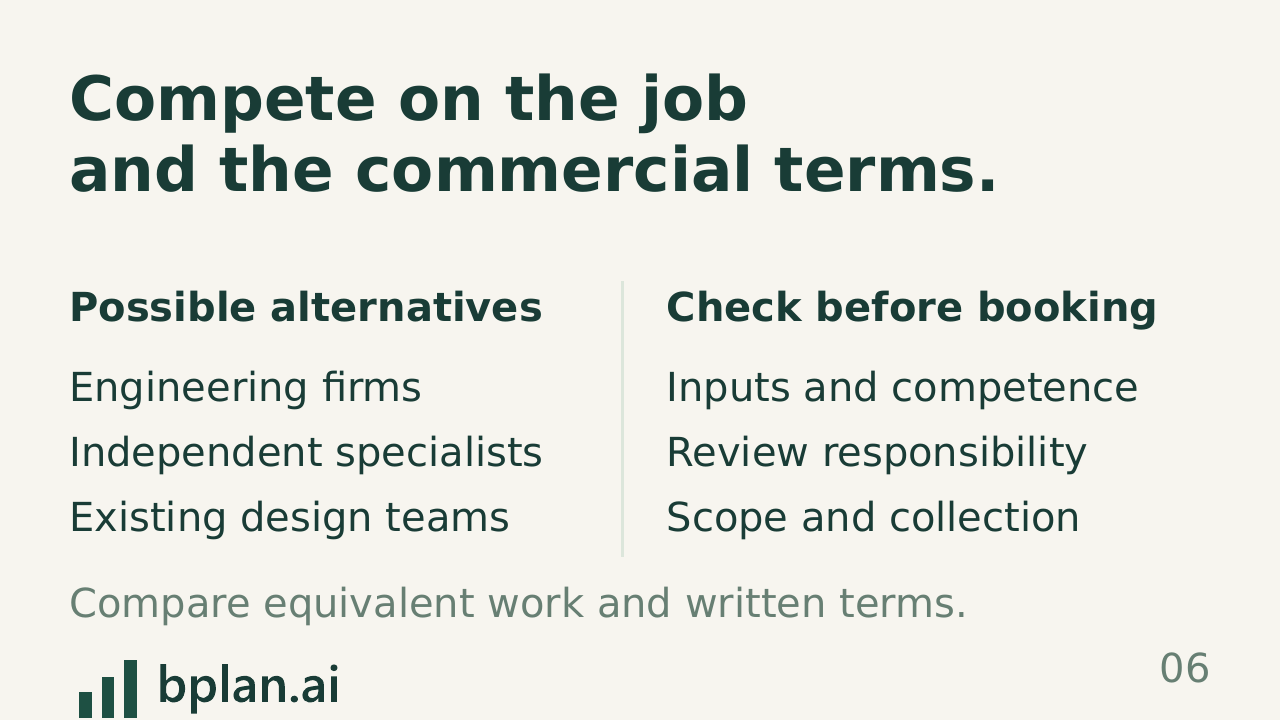

6. Compete on the job and the commercial terms.
Possible alternatives
Check before booking
Engineering firms
Inputs and competence
Independent specialists
Review responsibility
Existing design teams
Scope and collection
Compare equivalent work and written terms.

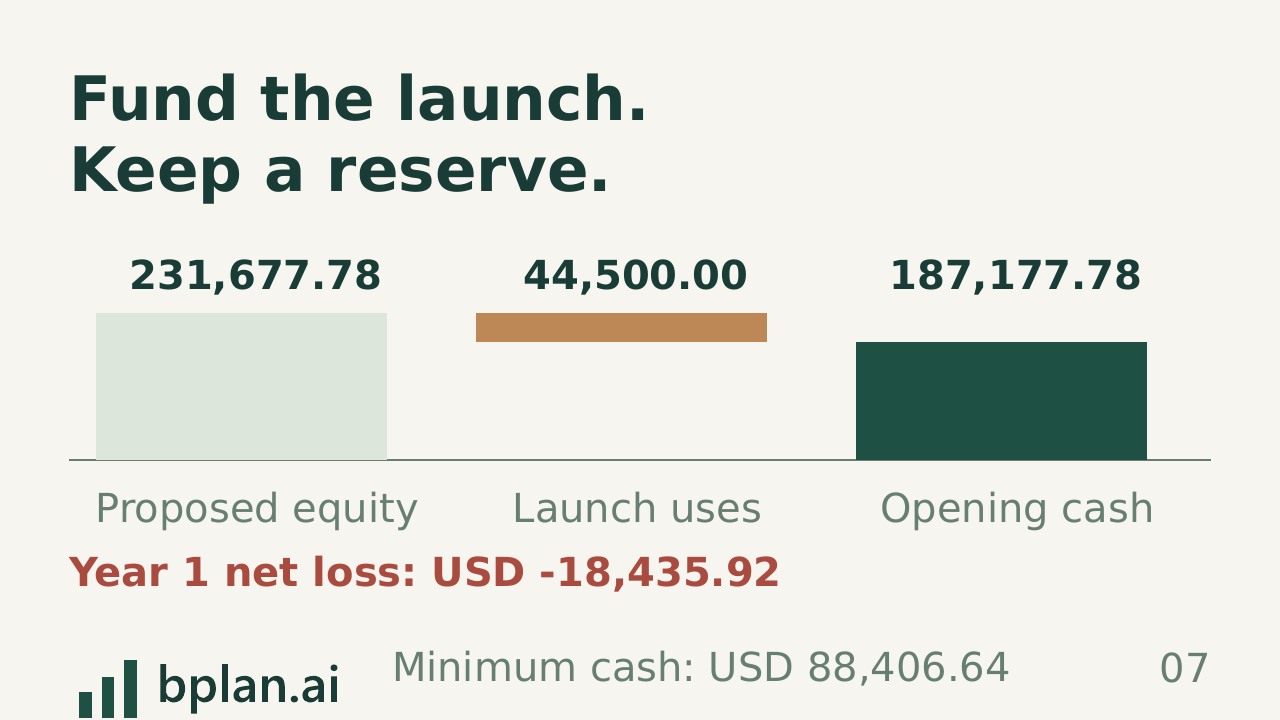

7. Fund the launch. Keep a reserve.
231,677.78
Proposed equity
44,500.00
Launch uses
187,177.78
Opening cash
Year 1 net loss: USD -18,435.92
Minimum cash: USD 88,406.64

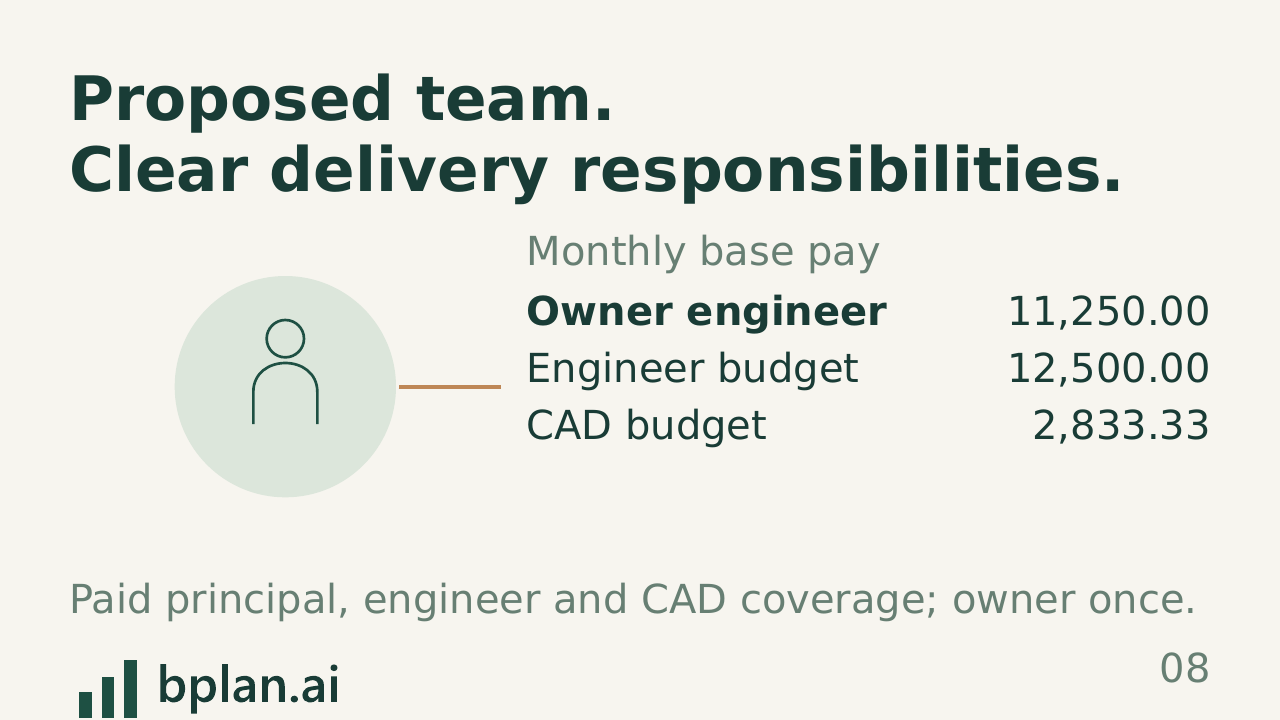

8. Proposed team. Clear delivery responsibilities.
Monthly base pay
Owner engineer
11,250.00
Engineer budget
12,500.00
CAD budget
2,833.33
Paid principal, engineer and CAD coverage; owner once.

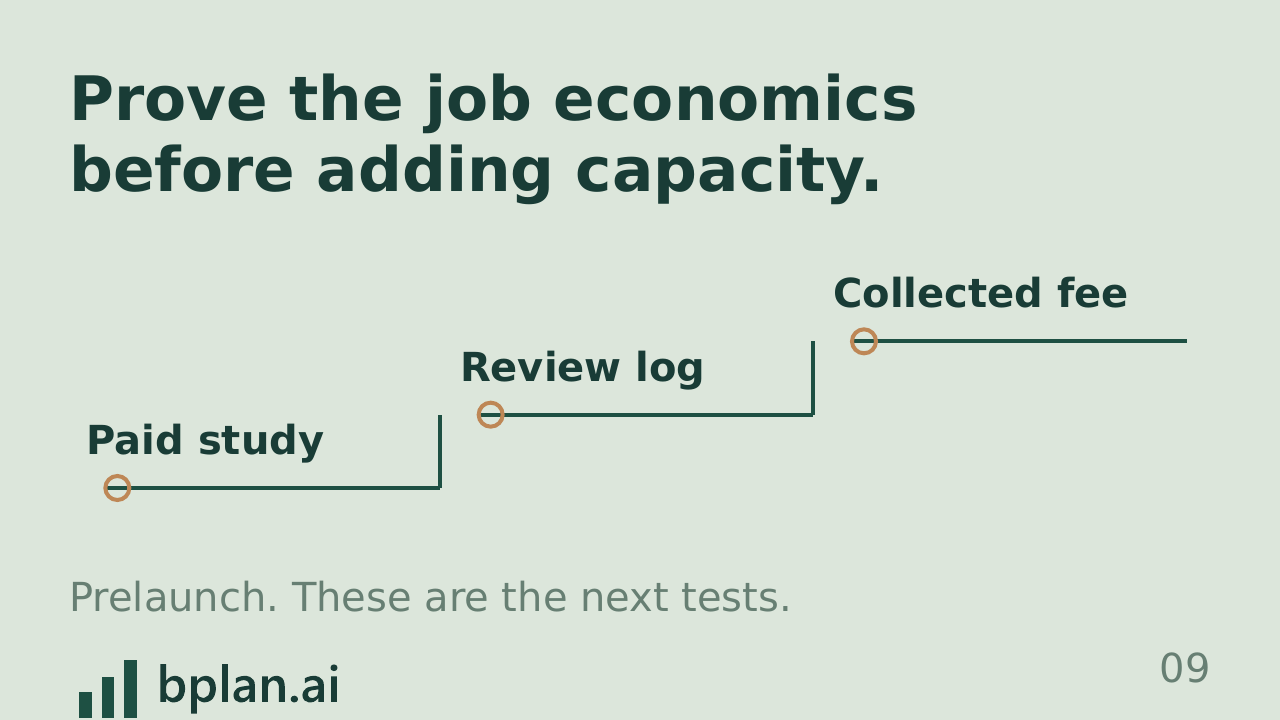

9. Prove the job economics before adding capacity.
Paid study
Review log
Collected fee
Prelaunch. These are the next tests.

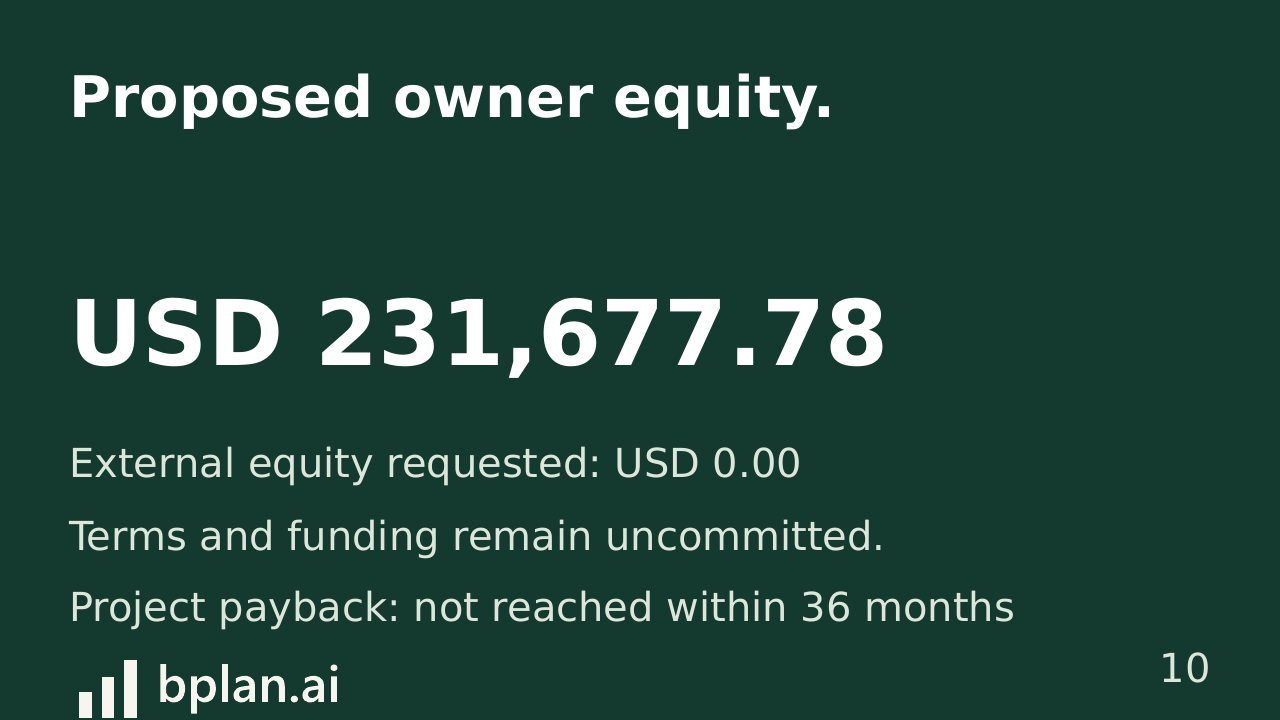

10. Proposed owner equity.
USD 231,677.78
External equity requested: USD 0.00
Terms and funding remain uncommitted.
Project payback: not reached within 36 months
KEEP THE COMPLETE EXAMPLE
Three matching documents.
Free fictional sample PDFs. Actual page counts and byte sizes are shown below.
Business plan
12 pages · A4 portrait
96,744 bytes · PDF
Financial report
7 pages · A4 landscape
62,803 bytes · PDF
Pitch deck
10 pages · 16:9 landscape
47,139 bytes · PDF
Build around your own decisions.
Use your own service boundary, actual quotes, paid staffing and payment terms. Review every assumption before preparing your own package.
Create a plan like this ↗
