THE COMPLETE BUSINESS PLAN
A specific operating decision.
Can earned monthly renovation progress support site supervision and purchased trade work without confusing bookings with collected cash?
Fictional editorial scenario. Prices, workload, wages, costs and financing are illustrative planning inputs, not current quotes, measured local averages or actual company results.
All three operating years show positive modeled net income. Positive funded cash assumes the full proposed equity is received; it does not establish commercial viability.
01 / THE PLAN
Executive summary
Timberline Works proposes a owner-managed renovation general contractor in Mid-cost US metropolitan area; jurisdiction to be selected. A proposed general contractor delivering residential renovation, additions and small commercial fitouts through paid site supervision/carpentry and purchased specialist trade packages. The central launch decision is: Can earned monthly renovation progress support site supervision and purchased trade work without confusing bookings with collected cash?
Business overview
Property owners and small commercial occupants commissioning defined renovation work, with authority to approve progress, changes, access and payment. Eight average active project-months are allocated once across five renovation types. Each category earns its selected monthly progress fee for work performed, rather than booking a whole contract every month. The same source first-year project scale is retained throughout; it is a workload assumption, not proof of site capacity. Customer deposits, retentions and unbilled work are outside this bounded forecast. The business will accept assignments within this service boundary and quote separately or refer work that falls outside it.
Key priorities
Seek a real, limited paid scope and document accepted estimates, authorized changes, completed progress and collection. Eight average active projects are a scenario, not an existing backlog or verified capacity. The commercial test includes trade availability and site supervision as well as willingness to sign a contract. A project inquiry, full contract booking and earned monthly progress are distinct stages and must not be added together as revenue. The proposed first operating month is January 2027. The owner should confirm service readiness, paid staffing and available cash before opening the calendar.
Financial highlights
The proposal requires $800,000.00 in equity. Launch spending is $204,000.00, leaving $596,000.00 in opening cash. Year 1 revenue is $1,997,600.02 and net income is $79,491.12. A positive first-year result depends on achieving the proposed fees and workload while keeping delivery within the paid team’s capacity. Pre-tax project payback is 19.5 months.
02 / THE PLAN
Company & management
Timberline Works will operate as an independent service business. The working owner will control scope, staffing, commercial terms and weekly cash decisions; legal formation and the ownership agreement must be completed before trading.
Company background
Timberline Works is a fictional owner-managed general contractor for a mid-cost US metropolitan area that has not yet been selected. It combines residential renovation/additions with small commercial fitouts, using an office/storage base and two fitted vans. It does not operate a speculative property-development business. No actual entity, site, credential, signed project or approval is supplied; the real jurisdiction and operating permissions must be established.
Ownership & management
The proposed owner contribution is $500,000.00; the remaining $300,000.00 is sought from external equity investors. The owner is also paid for an operating role. Investment valuation, ownership percentages, voting rights and distribution terms remain to be agreed.
Team & responsibilities
The paid roster is one site supervisor, two in-house carpenters, one owner-manager and half-time office coordination. The owner sells, scopes, coordinates and manages cash without creating another carpenter or supervisor. Specialist trade packages are purchased outside payroll and include their own scoped provider resources. Salaried site roles and office roles are all paid once. A real site schedule must verify coverage, competence, travel and simultaneous-project responsibilities. Site supervisor: 1 × $7,500.00 monthly, plus a 15% employer-cost allowance; Carpenters: 2 × $5,000.00 monthly, plus a 15% employer-cost allowance; Owner-manager: 1 × $9,166.67 monthly, plus a 15% employer-cost allowance; Office coordination: 1 × $2,291.67 monthly, plus a 15% employer-cost allowance. A weekly roster must cover delivery, preparation, travel, administration, leave and absence. The owner’s salary appears once in payroll; contributed time is not an additional cash contribution.
03 / THE PLAN
Products & business model
The offer is limited to work the team can define, price and deliver consistently. Each agreement should identify the buyer, included tasks, access requirements, deliverables, acceptance and payment terms.
Products & services
Five work types are kitchen renovations, bathroom renovations, structural renovations, home additions and small commercial fitouts. The monthly price represents earned progress for one active project-month at the stated scope, not a quote for a complete kitchen, addition or contract. One project may contribute progress over several months. Directly bought materials are separated from trade packages, which may include their own materials; the same purchase is not counted twice.
Pricing & revenue streams
8 active earned project-months are requested monthly before the 3-month ramp, capped at 8 project-months across five exclusive work types. Each unit recognizes one month of completed, certified progress at its work-type price, not a whole contract, new inquiry, deposit or employee hour. Requested volume grows 0% annually, within that scenario ceiling; prices grow 2%. This simplified monthly earned-work proxy does not prove signed projects, scheduling feasibility, stage duration or collection. Test those conditions before accepting the workload. Kitchens: 25% of the shared capacity at $18,000.00 per earned project-month. Bathrooms: 25% of the shared capacity at $12,000.00 per earned project-month. Structural work: 20% of the shared capacity at $25,000.00 per earned project-month. Home additions: 20% of the shared capacity at $35,000.00 per earned project-month. Commercial: 10% of the shared capacity at $32,000.00 per earned project-month. Fees exclude customer sales tax. Confirm scope and any exceptional materials before accepting a fixed price.
Customer value
The proposed value is an agreed scope, coordinated trades, documented progress and a clear change/acceptance process. The customer needs to understand what the monthly progress represents and which decisions or approvals can delay it. A forecast does not establish permission to carry out structural work, guaranteed completion dates or a defect-free result. Actual design, qualification and inspection responsibilities must be agreed for each project.
04 / THE PLAN
Market & competition
The initial market is the specific buyer and buying occasion described below. The launch should be justified by paid work in a practical service area, rather than by applying a market-share percentage to a broad industry estimate.
Target customers
Property owners and small commercial occupants commissioning defined renovation work, with authority to approve progress, changes, access and payment. Confirm who commissions the work, who supplies access or records and who authorizes payment. Keep the initial territory small enough to support the promised response and delivery time.
Demand & validation
Seek a real, limited paid scope and document accepted estimates, authorized changes, completed progress and collection. Eight average active projects are a scenario, not an existing backlog or verified capacity. The commercial test includes trade availability and site supervision as well as willingness to sign a contract. A project inquiry, full contract booking and earned monthly progress are distinct stages and must not be added together as revenue.
Competition & positioning
Alternatives are other general contractors, a design-build provider or separately commissioned suitable trades under an arrangement the owner is able to manage. Compare scope, design responsibility, trade coordination, progress documentation, changes and payment terms. A full-project quote is not directly comparable to this model’s monthly earned-progress fee. No local cost average, competitive ranking or industry margin comparison is claimed.
05 / THE PLAN
Marketing & sales
The acquisition process should bring in work that fits the team and produces collected contribution after delivery costs. Track qualified opportunities, accepted quotes, completed work and cash received as separate steps.
Customer acquisition
The proposed channels are relevant design/property introductions, clearly labeled sample scopes and appropriate referrals. The recurring demand-generation allowance is separate from launch promotion and paid owner time. Do not advertise a credential or project record that has not been established. Qualify work against real permissions, trade availability and the site calendar before accepting it as a commercial opportunity.
Sales process
Agree the work scope, responsibilities, authorized progress measurement, change approval, inspection/access conditions and payment schedule before commitment. The forecast invoices earned progress monthly with a seventeen-day collection assumption. It does not count customer advances, whole contract value or unapproved variations as current revenue. Retention, deposits, milestone exceptions and unbilled work require a separate cash review before real contract terms are signed.
Retention & measurement
After accepted work, document defects, agreed rectification and any new paid scope. A follow-on project must be separately authorized; it is not an assumed annual renewal. Use completed-job information and photographs only with permission and clear limits on any claimed result. The example supplies no completed client projects, warranty performance series or contracted repeat pipeline.
06 / THE PLAN
Operations & milestones
Delivery must fit the paid team’s hours, equipment and service window. Work should enter the calendar only after scope, competence, access and required resources are confirmed.
Facilities & resources
Launch assets are two fitted vans, power tools/saws, trailers/storage, scaffold/access equipment and office computers. Heavy job equipment is rented in direct costs rather than purchased again as a fleet. Stock covers directly purchased construction materials only; subcontract services cannot be held as inventory. Confirm vehicle/tool specifications, actual office/deposit terms, trade package exclusions, site access and configured insurance before committing the allowances. The launch asset budget is Two fitted construction vans: $110,000.00; Durable power tools and saws: $25,000.00; Work trailers and secure storage: $12,000.00; Scaffold and safety access: $15,000.00; Computers and office equipment: $6,000.00.
Service delivery
Confirm scope and project readiness, coordinate actual design/permission responsibilities, order materials and trade packages, supervise agreed work, document earned progress and obtain acceptance for billing. Use a dated site/trade plan rather than treating an average active-project count as a technical staffing rule. Review hazardous-material and lead-related applicability and competence before relevant renovation work; no completed specialist or legal assessment is supplied. Changes need an authorized price and schedule decision.
Launch & development milestones
Before opening, select the jurisdiction, verify contractor/trade capability, insurance and applicable permissions, and obtain real site, equipment and supplier terms. Complete a paid limited scope with documented progress, change control and collection. Inspect working cash before committing to several overlapping sites. January 2027 is a modeling start date; there is no awarded job, approved permit or committed trade roster.
07 / THE PLAN
Funding request & use of funds
All proposed equity must be available before launch payments. The funding plan separates equipment and setup spending from the cash reserve needed to support operations.
Use of funds
Launch spending totals $204,000.00: $168,000.00 for assets, $18,000.00 for expensed setup and $18,000.00 for opening inventory. Setup covers an allowance for formation, professional preparation, training and launch work. Refundable premises deposits and additional site work are excluded until scoped quotes are available.
Sources of funding
Total proposed equity is $800,000.00, comprising $500,000.00 from the owner and $300,000.00 from external investors. Neither contribution is committed. No borrowing is included, and financing receipts are separate from earned revenue.
Owner contribution
The owner must confirm the availability and transfer date of the $500,000.00 contribution. Salary pays for the owner’s continuing operating work. The company still needs cash for payroll, equipment and supplier invoices, even when the owner contributes additional time.
Funding request
The external equity request is $300,000.00. Receiving all proposed equity leaves $596,000.00 of opening cash and a forecast funding gap of $0.00. The gap measures a cash shortfall after assumed funding; it is not a substitute for the investment request. Agree investor rights and reporting before accepting funds.
08 / THE PLAN
Financial plan
The forecast covers January 2027–December 2029 in USD, with launch spending reported separately. Its usefulness depends on the service mix, fee, staffing cost and collection terms below.
Forecast assumptions
8 active earned project-months are requested monthly before the 3-month ramp, capped at 8 project-months across five exclusive work types. Each unit recognizes one month of completed, certified progress at its work-type price, not a whole contract, new inquiry, deposit or employee hour. Requested volume grows 0% annually, within that scenario ceiling; prices grow 2%. This simplified monthly earned-work proxy does not prove signed projects, scheduling feasibility, stage duration or collection. Test those conditions before accepting the workload. Direct costs are 64.5% of net fees. Only purchased materials enter inventory; outside services are not stocked. Salaries are operating expenses, outside the direct-cost ratio. Salaries and fixed overhead grow 3% annually. Collections take 17 days, supplier payments 10 days and inventory coverage 10 days. The 21% flat income-tax provision and 15% employer-cost allowance are simplified planning inputs.
Financial outlook
Year 1: revenue $1,997,600.02, EBITDA $144,214.12, net income $79,491.12 and closing cash $647,118.45. Year 2: revenue $2,222,784.00, EBITDA $200,926.68, net income $130,568.60 and closing cash $811,696.60. Year 3: revenue $2,267,239.68, EBITDA $199,908.12, net income $129,763.88 and closing cash $975,437.22. A positive first-year result depends on achieving the proposed fees and workload while keeping delivery within the paid team’s capacity. EBITDA excludes depreciation, interest and income tax; net income includes depreciation and the tax provision.
Cash needs & financial resilience
The lowest forecast cash balance is $523,965.94, and the funding gap is $0.00. Positive monthly operating EBITDA is first reached in month 3. Pre-tax project payback is 19.5 months. Cash differs from profit because of equipment spending, depreciation, collection delays and financing. Review the monthly low point before committing the reserve.
Debt & repayment
No debt or investor distributions are included. Any borrowing option needs an amount, draw date, interest rate and repayment schedule before its affordability can be assessed. Pre-tax project payback measures recovery of the operating investment; it is not a promised dividend, investor return or financing approval.
09 / THE PLAN
Risks & contingencies
The main exposure is committing paid resources before collected sales justify them. The owner should use the service-specific risks below to decide when to narrow the offer, defer spending or stop.
Key risks
Unapproved changes, hidden site conditions, unsuitable materials, trade delays, defects and late progress payments can consume cash before profit is collected. A single supervisor’s ability to oversee the assumed project mix has not been proved. The model does not carry a detailed construction backlog, contract asset, retention or customer-deposit schedule. These omissions and unresolved hazardous-material conditions can change the funding need materially.
Contingency actions
Use a scoped estimate, readiness and qualification checks, a dated trade schedule and written progress/change acceptance. Review purchased materials and trade packages so employee pay or included components are not charged twice. Test delayed progress, later customer payment, loss of supplier terms and callbacks while retaining all paid roles. Defer commitments when the actual contract or site cash cycle does not fit the reserve, rather than treating new bookings as cash.
10 / THE PLAN
Supporting documents
The launch decision needs commercial evidence as well as a forecast. Maintain an organized working file so that costs, commitments and delivery capacity can be reviewed before money is spent.
Available supporting information
The operating proposal defines the customer, service boundary, paid roles, launch assets and collection terms. The accompanying annual financial statements set out earnings, cash flow and the balance sheet for the three-year period. All funding remains a proposal; the business is at the prelaunch stage.
Documents to obtain
Jurisdiction-specific contractor/trade permissions, suitable design and hazardous-material review, site supervision and trade agreements, actual contracts/progress/payment and retention terms, configured insurance, material/equipment/office-deposit quotes, paid project records and equity commitments remain outstanding. No issued permit, lead-related certification, engineering approval, awarded contract, supplier credit or committed investor is supplied. Record the actual fee, total delivery effort and date of payment for each trial assignment. Update the forecast and funding decision when quotes, commitments or measured results change a material assumption.
02 / THE FINANCIAL MODEL
How this business earns and uses cash.
8 active earned project-months are requested monthly before the 3-month ramp, capped at 8 project-months across five exclusive work types. Each unit recognizes one month of completed, certified progress at its work-type price, not a whole contract, new inquiry, deposit or employee hour. Requested volume grows 0% annually, within that scenario ceiling; prices grow 2%. This simplified monthly earned-work proxy does not prove signed projects, scheduling feasibility, stage duration or collection. Test those conditions before accepting the workload.
The forecast covers three operating years, with prelaunch spending shown separately. Fees, workload, staffing and collection terms determine whether the business can cover its commitments and preserve cash.
| Service | Pool allocation | Base price | Billing unit |
|---|---|---|---|
| Kitchens | 25% | $18,000.00 | One earned project-month |
| Bathrooms | 25% | $12,000.00 | One earned project-month |
| Structural work | 20% | $25,000.00 | One earned project-month |
| Home additions | 20% | $35,000.00 | One earned project-month |
| Commercial | 10% | $32,000.00 | One earned project-month |
| Cost or paid role | Base input | Treatment |
|---|---|---|
| Site supervisor | $7,500.00/month before employer costs | Paid role; 15% employer allowance |
| Carpenters | $10,000.00/month before employer costs | Paid role; 15% employer allowance |
| Owner-manager | $9,166.67/month before employer costs | Paid role; 15% employer allowance |
| Office coordination | $2,291.67/month before employer costs | Paid role; 15% employer allowance |
| Office and storage rent | $2,500.00/month before employer costs | Operating expense |
| Utilities and communications | $450.00/month before employer costs | Operating expense |
| Liability property worksite cover | $1,800.00/month before employer costs | Operating expense |
| Vehicle running and insurance | $1,000.00/month before employer costs | Operating expense |
| Tool upkeep and small consumables | $500.00/month before employer costs | Operating expense |
| Estimating and project software | $400.00/month before employer costs | Operating expense |
| Accounting and legal | $600.00/month before employer costs | Operating expense |
| Licensing and safety training | $200.00/month before employer costs | Operating expense |
| Demand generation | 2.5% of net fees | Operating expense |
| Payment and collection | 0.3% of net fees | Operating expense |
| Warranty and callbacks | 1% of net fees | Operating expense |
| Input | Case value |
|---|---|
| Collection delay | 17 days |
| Inventory / supplier payment | 10 days / 10 days |
| Direct costs | 64.5% of net fees |
| Price / requested-demand growth | 2% / 0% annually |
| Salary and fixed-cost growth | 3% annually |
| Income-tax provision | 21% simplified provision |
| Proposed owner equity | $500,000.00 |
| Proposed external equity | $300,000.00 |
| Prelaunch setup | $18,000.00 |
Direct costs cover 64.5% of fees and exclude the paid roles already shown in operating expenses. The material share uses the purchased-stock ledger; outside services remain direct expenses. All-in customer prices are not duplicated as extra parts or product revenue.
What the forecast shows
All three operating years show positive modeled net income. Net income includes depreciation and the monthly tax provision. EBITDA excludes depreciation, interest and tax; cash also reflects assets, working capital and financing.
| Measure | Year 1 · 2027 | Year 2 · 2028 | Year 3 · 2029 |
|---|---|---|---|
| Revenue | $1,997,600.02 | $2,222,784.00 | $2,267,239.68 |
| Cost of sales | $1,288,452.02 | $1,433,695.68 | $1,462,369.56 |
| Gross profit | $709,148.00 | $789,088.32 | $804,870.12 |
| Operating expenses | $564,933.88 | $588,161.64 | $604,962.00 |
| EBITDA | $144,214.12 | $200,926.68 | $199,908.12 |
| Depreciation | $35,650.00 | $35,650.00 | $35,650.00 |
| Interest | $0.00 | $0.00 | $0.00 |
| Tax provision | $29,073.00 | $34,708.08 | $34,494.24 |
| Net income | $79,491.12 | $130,568.60 | $129,763.88 |
| Measure | Year 1 · 2027 | Year 2 · 2028 | Year 3 · 2029 |
|---|---|---|---|
| Opening cash | $596,000.00 | $647,118.45 | $811,696.60 |
| Customer collections | $1,894,693.35 | $2,220,725.87 | $2,265,140.38 |
| Supplier payments | $1,249,568.02 | $1,433,278.00 | $1,461,943.52 |
| Operating expenses paid | $564,933.88 | $588,161.64 | $604,962.00 |
| Interest paid | $0.00 | $0.00 | $0.00 |
| Tax provision paid | $29,073.00 | $34,708.08 | $34,494.24 |
| Operating cash flow | $51,118.45 | $164,578.15 | $163,740.62 |
| Investing cash flow | $0.00 | $0.00 | $0.00 |
| Financing cash flow | $0.00 | $0.00 | $0.00 |
| Net change | $51,118.45 | $164,578.15 | $163,740.62 |
| Closing cash | $647,118.45 | $811,696.60 | $975,437.22 |
| Measure | Year 1 · 2027 | Year 2 · 2028 | Year 3 · 2029 |
|---|---|---|---|
| Cash | $647,118.45 | $811,696.60 | $975,437.22 |
| Receivables | $102,906.67 | $104,964.80 | $107,064.10 |
| Inventory | $18,160.00 | $18,523.20 | $18,893.66 |
| Net fixed assets | $132,350.00 | $96,700.00 | $61,050.00 |
| Assets | $900,535.12 | $1,031,884.60 | $1,162,444.98 |
| Payables | $39,044.00 | $39,824.88 | $40,621.38 |
| Loan balance | $0.00 | $0.00 | $0.00 |
| Liabilities | $39,044.00 | $39,824.88 | $40,621.38 |
| Equity and retained earnings | $861,491.12 | $992,059.72 | $1,121,823.60 |
| Reconciliation difference | $0.00 | $0.00 | $0.00 |
Launch spending is $204,000.00; opening cash is $596,000.00 after all proposed equity. The unfunded gap is $0.00. Pre-tax project payback is 19.5 months. Project recovery is not an investor distribution.
Inspect the actual report
Planning limits and qualifications
Planning model, not audited accounts or tax advice. Revenue is invoiced as earned; monthly subscriptions only. Annual prepayments, refundable deposits, milestone invoices, unbilled contract assets, customer taxes, seller settlements, capitalized interest and tax-loss carryforwards are not modeled.
Collection and supplier terms use 30-day monthly interpolation. Inventory purchases and non-stock direct costs use supplier terms; operating costs, setup costs, taxes and opening stock are paid immediately. Stock coverage applies only to linked goods costs. Production stock is tracked separately at unit cost.
Fictional editorial scenario. Prices, workload, wages, costs and financing are illustrative planning inputs, not current quotes, measured local averages or actual company results.
Five-year source adapted to 36 months at eight active project-months, original mix and earned monthly fees. Staffing fixed: supervisor, two carpenters, paid owner and half-time office. No future project-count expansion; three-month ramp, 2% fee and 3% payroll/overhead growth. Direct costs 64.5%, including 30% goods and 30% trade packages; only goods stocked for ten physical days. Payment lag ten days is an explicit blended purchase assumption, not all suppliers on credit. Setup paid once; equity proposed, deposits/WIP/retentions excluded. Tax/employer allowance illustrative.
A 15% illustrative employer allowance is added to paid salaries. The flat 21% native tax provision is a simplified planning input, not an entity or personal tax opinion. Customer sales-tax receipts/remittances and owner distributions are outside this scenario.
All equity is proposed, uncommitted month-0 cash. No debt is modeled. Opening cash is a reserve, not an extra startup expense. Asset/setup/insurance/premises allowances need scoped quotes; refundable premises deposits and site-specific additional works are excluded.
Fictional editorial scenario. Prices, workload, wages, costs and financing are illustrative planning inputs, not current quotes, measured local averages or actual company results.
Five-year source adapted to 36 months at eight active project-months, original mix and earned monthly fees. Staffing fixed: supervisor, two carpenters, paid owner and half-time office. No future project-count expansion; three-month ramp, 2% fee and 3% payroll/overhead growth. Direct costs 64.5%, including 30% goods and 30% trade packages; only goods stocked for ten physical days. Payment lag ten days is an explicit blended purchase assumption, not all suppliers on credit. Setup paid once; equity proposed, deposits/WIP/retentions excluded. Tax/employer allowance illustrative.
A 15% illustrative employer allowance is added to paid salaries. The flat 21% native tax provision is a simplified planning input, not an entity or personal tax opinion. Customer sales-tax receipts/remittances and owner distributions are outside this scenario.
All equity is proposed, uncommitted month-0 cash. No debt is modeled. Opening cash is a reserve, not an extra startup expense. Asset/setup/insurance/premises allowances need scoped quotes; refundable premises deposits and site-specific additional works are excluded.
03 / ACTUAL TEN-SLIDE PITCH
A focused funding conversation.
All ten pages of the delivered PDF. Buyer demand, team roles and funding remain proposed.
Timberline Works
Every slide is available in the complete ten-slide PDF. The full slide text follows.
Read the complete slide outline
1. Timberline Works
Defined work. Documented monthly progress.
Fictional prelaunch

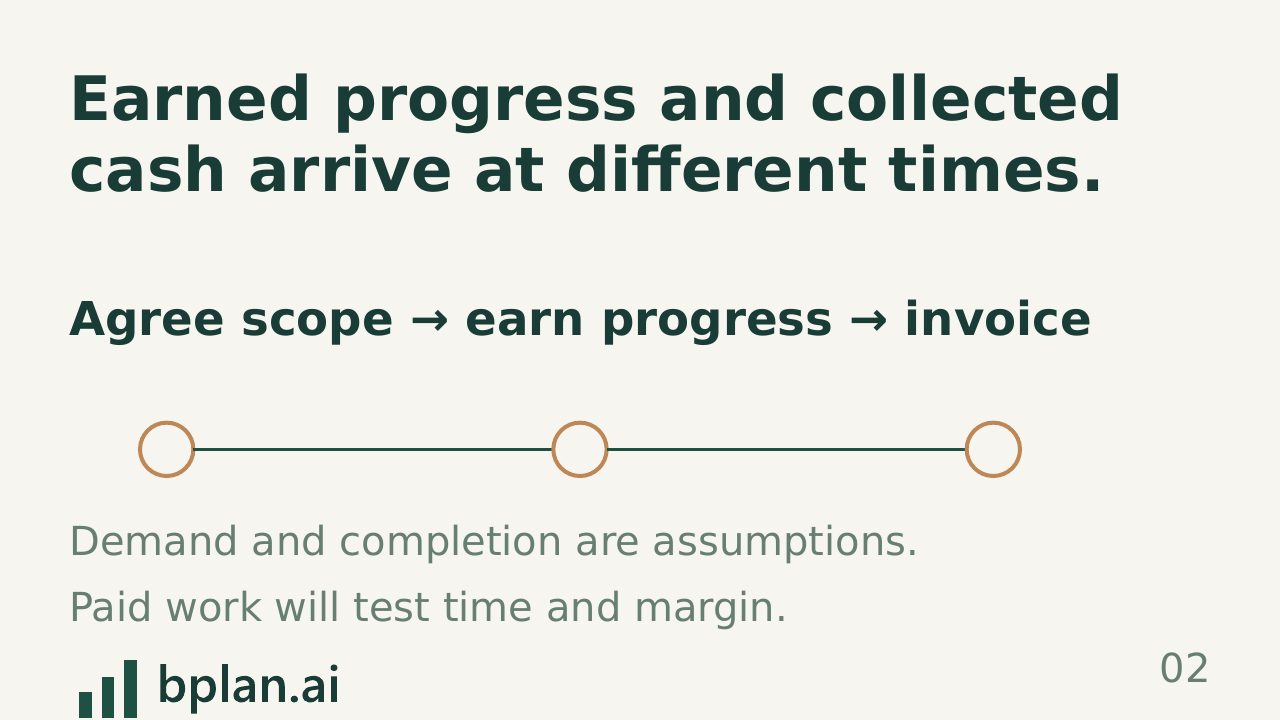

2. Earned progress and collected cash arrive at different times.
Agree scope → earn progress → invoice
Demand and completion are assumptions.
Paid work will test time and margin.
3. A clear scope. A controlled delivery process.
Agree
Schedule
Deliver
Collect
One agreed scope. Documented acceptance.

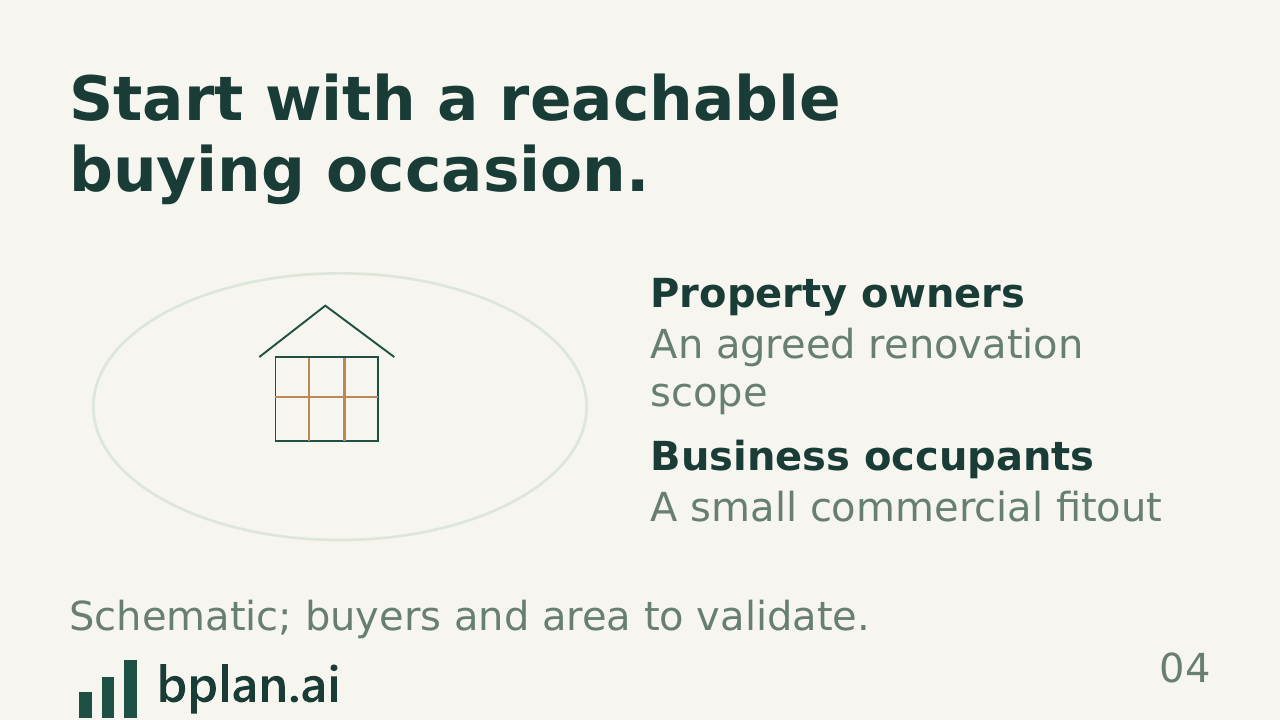

4. Start with a reachable buying occasion.
Property owners
An agreed renovation scope
Business occupants
A small commercial fitout
Schematic; buyers and area to validate.

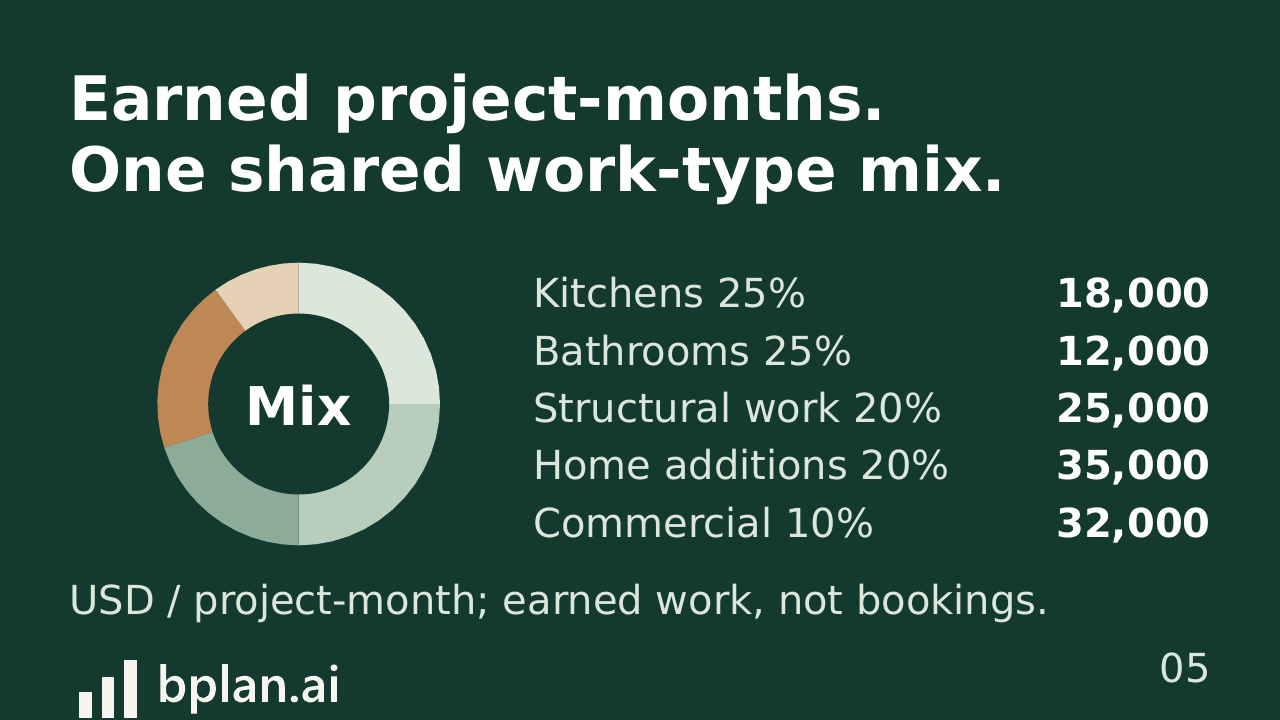

5. Earned project-months. One shared work-type mix.
Mix
Kitchens 25%
18,000
Bathrooms 25%
12,000
Structural work 20%
25,000
Home additions 20%
35,000
Commercial 10%
32,000
USD / project-month; earned work, not bookings.

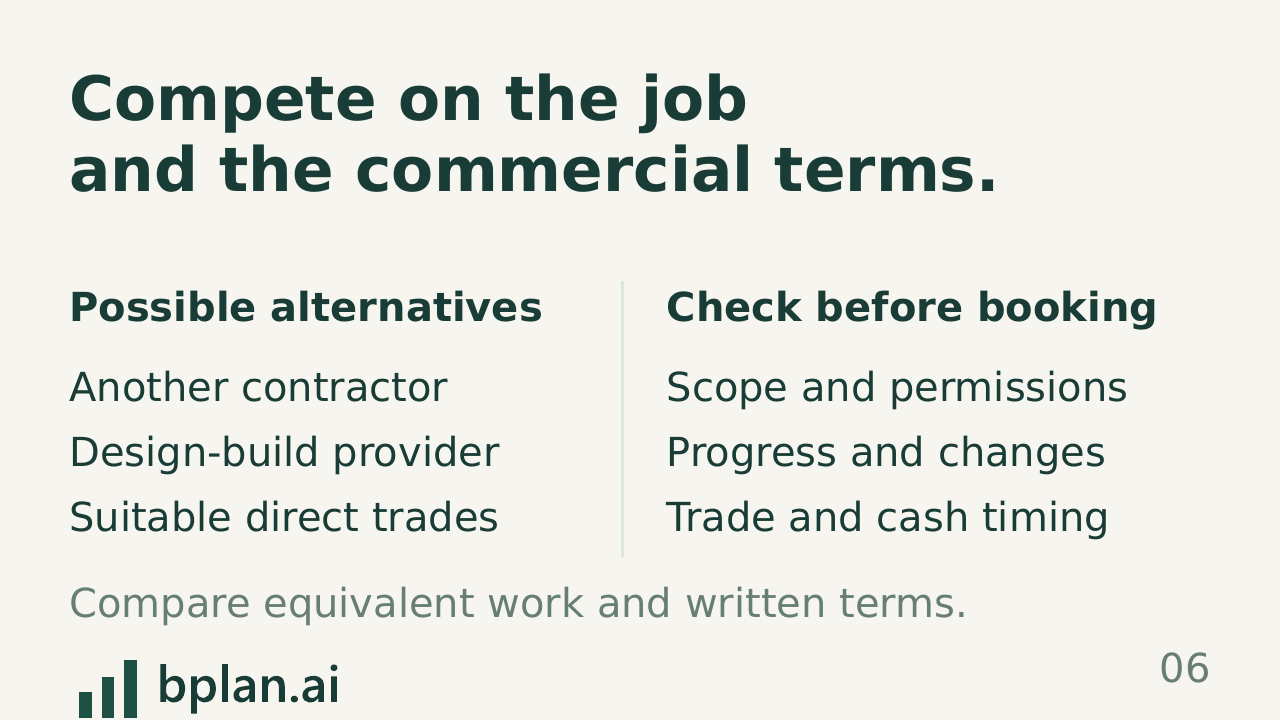

6. Compete on the job and the commercial terms.
Possible alternatives
Check before booking
Another contractor
Scope and permissions
Design-build provider
Progress and changes
Suitable direct trades
Trade and cash timing
Compare equivalent work and written terms.

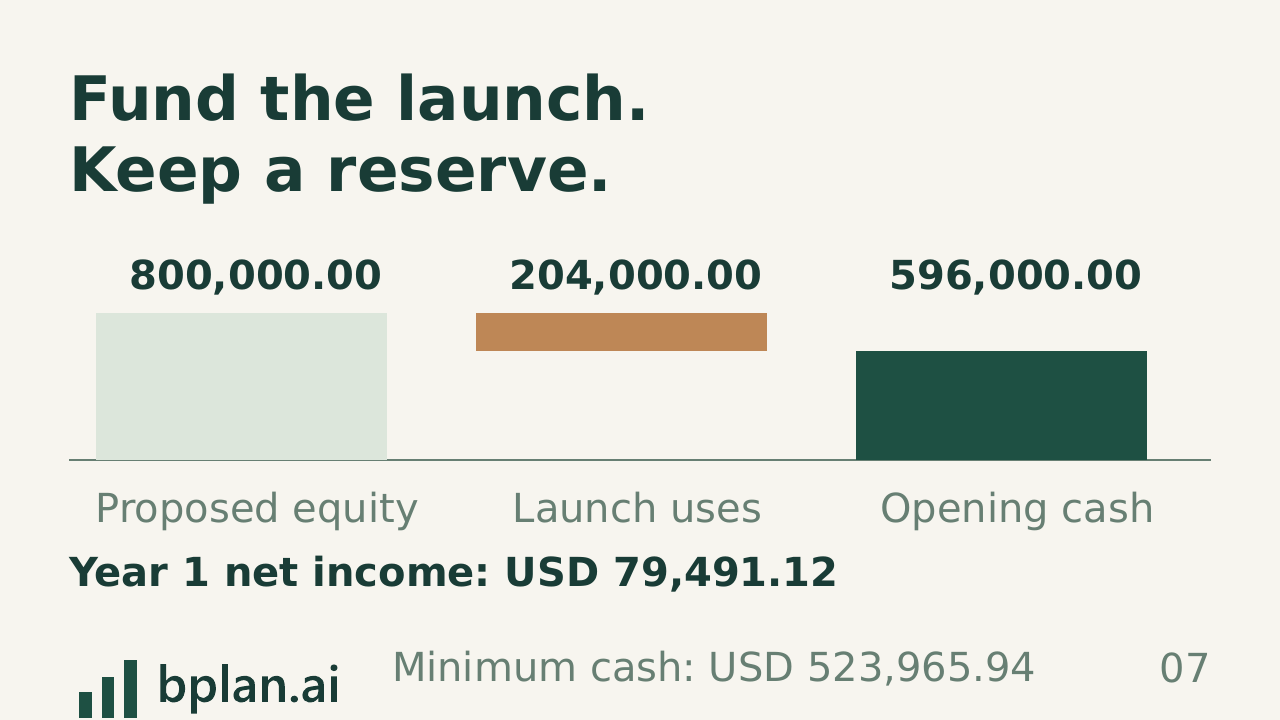

7. Fund the launch. Keep a reserve.
800,000.00
Proposed equity
204,000.00
Launch uses
596,000.00
Opening cash
Year 1 net income: USD 79,491.12
Minimum cash: USD 523,965.94

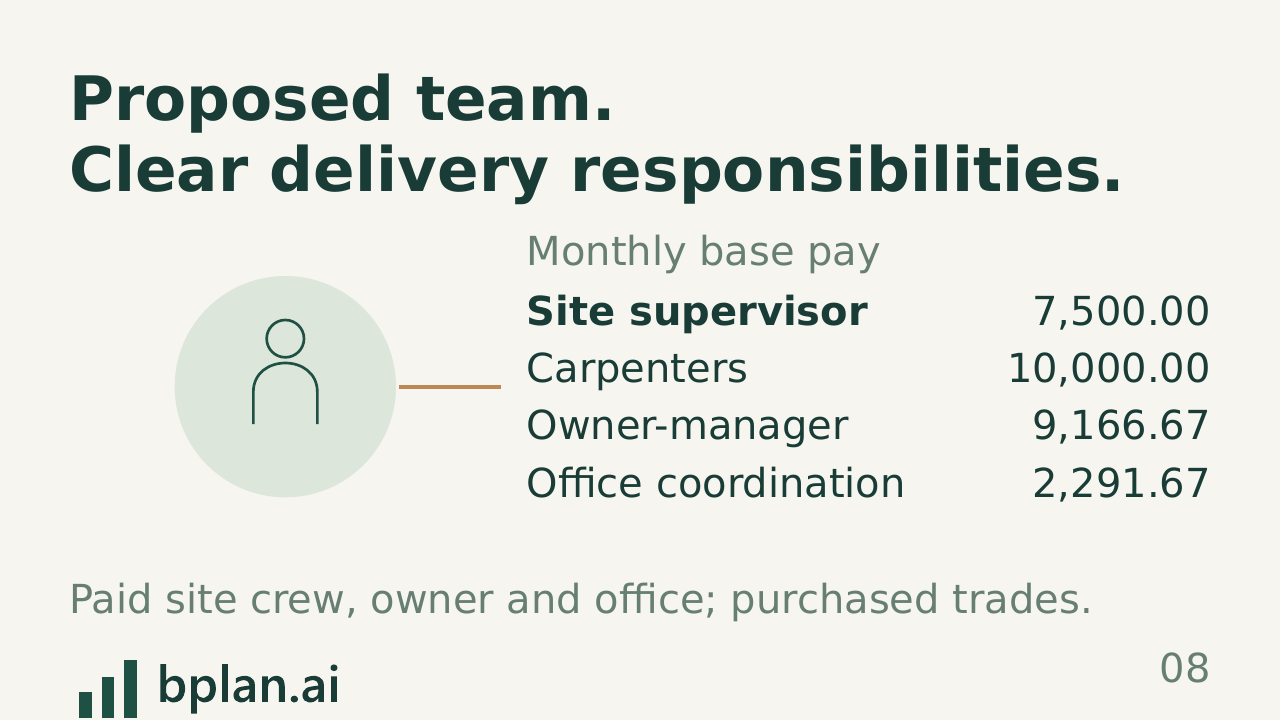

8. Proposed team. Clear delivery responsibilities.
Monthly base pay
Site supervisor
7,500.00
Carpenters
10,000.00
Owner-manager
9,166.67
Office coordination
2,291.67
Paid site crew, owner and office; purchased trades.

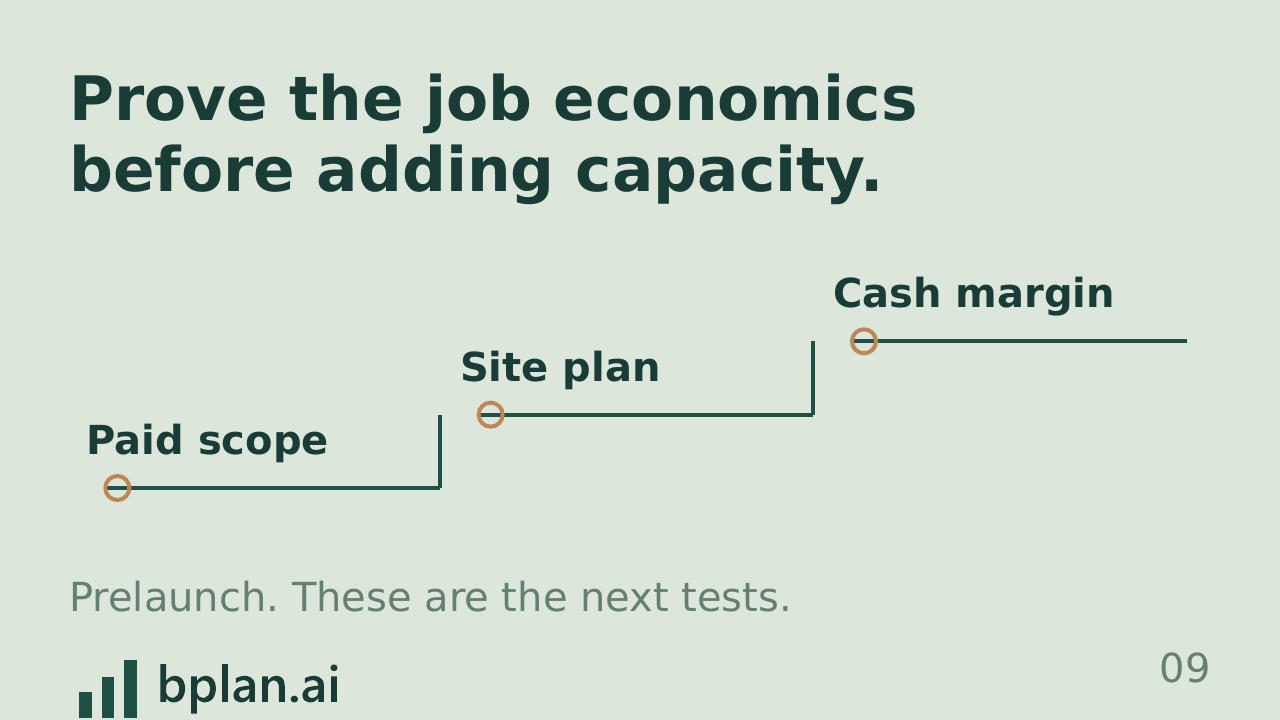

9. Prove the job economics before adding capacity.
Paid scope
Site plan
Cash margin
Prelaunch. These are the next tests.

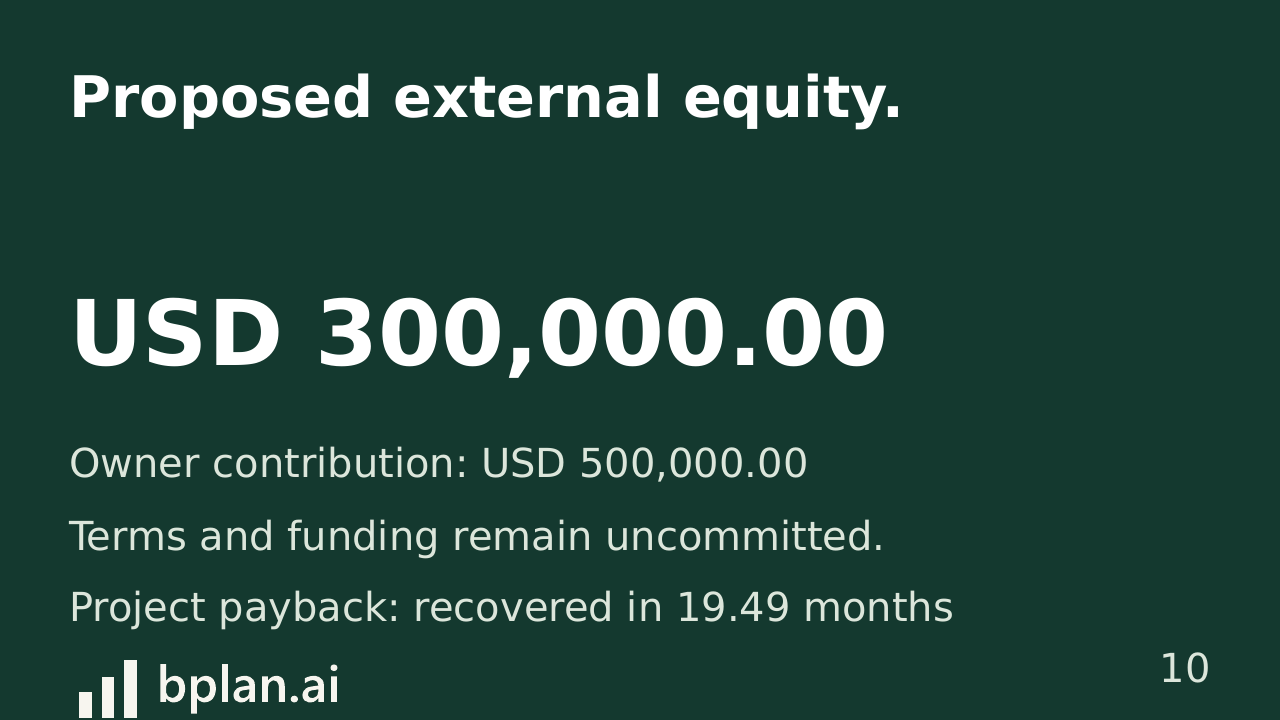

10. Proposed external equity.
USD 300,000.00
Owner contribution: USD 500,000.00
Terms and funding remain uncommitted.
Project payback: recovered in 19.49 months
KEEP THE COMPLETE EXAMPLE
Three matching documents.
Free fictional sample PDFs. Actual page counts and byte sizes are shown below.
Business plan
12 pages · A4 portrait
98,157 bytes · PDF
Financial report
7 pages · A4 landscape
63,144 bytes · PDF
Pitch deck
10 pages · 16:9 landscape
47,637 bytes · PDF
Build around your own decisions.
Use your own service boundary, actual quotes, paid staffing and payment terms. Review every assumption before preparing your own package.
Create a plan like this ↗
